Twenty-Three Seconds: Staging Backup Power Before We Needed It
A test report on the 30kVA UPS, staged 30kW generator, 23-second manual transfer, and the permanent automatic system that followed.
- Published
- Filed under
- field note

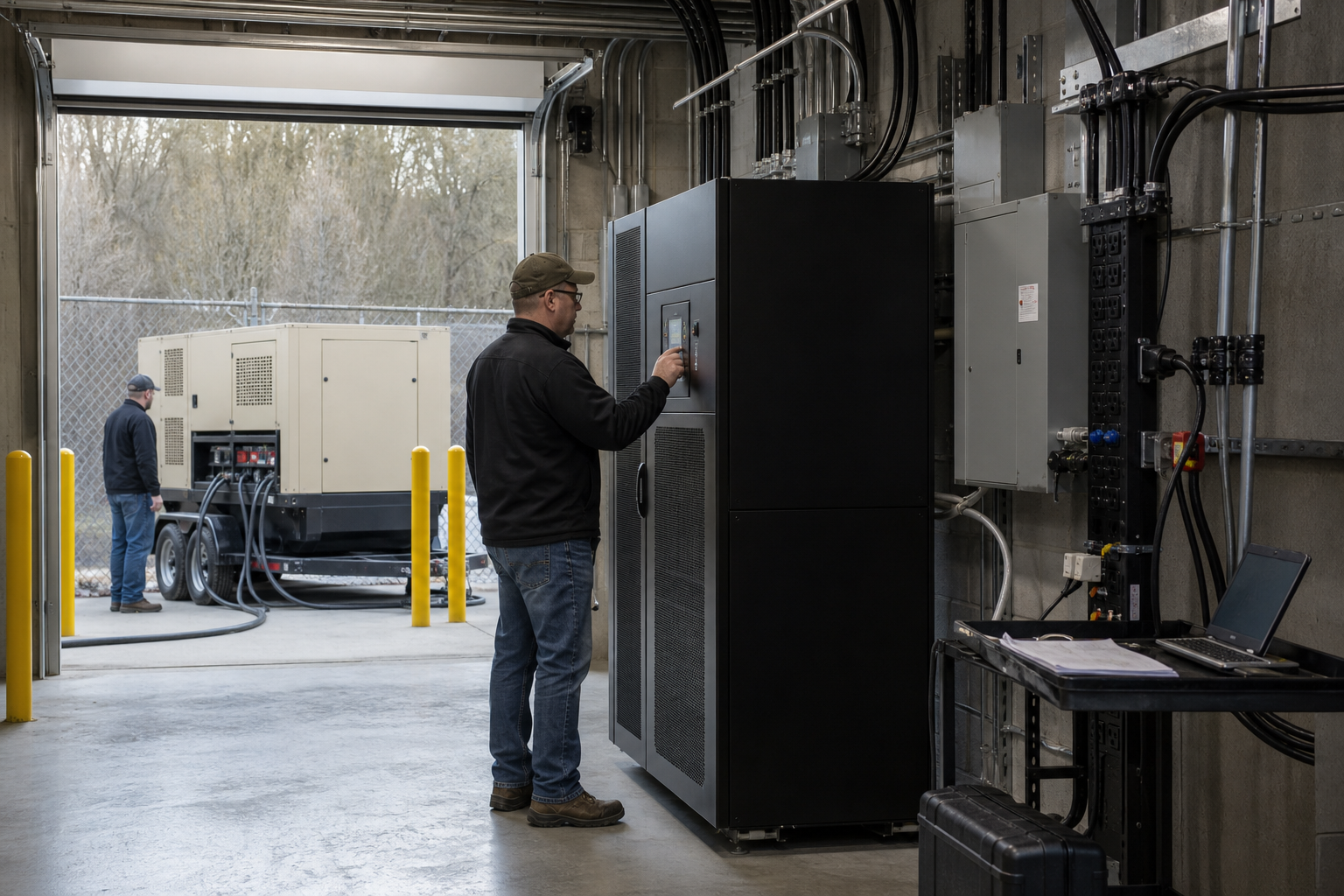

On July 4, 2023, Helixrack staged a rented 30kW towable generator for a planned storm-readiness test. A utility failure occurred while the team and rental unit were onsite. The 30kVA double-conversion UPS carried the protected IT load for 23 seconds while the generator was transferred manually. No server lost power.
That sequence is the central fact of the event. It was not a 23-second server outage, and the original 1500VA UPS did not carry the facility. The larger UPS installed in May supported the protected bus; the smaller unit protected network and control equipment only.
What was in place
The May expansion had added a refurbished 30kVA double-conversion UPS. Under normal operation, the system continuously conditioned power to the protected load. Stored energy was intended to bridge a transfer or controlled shutdown, not sustain an indefinite utility interruption.
For the July test, a 30kW rental generator was positioned and connected under the test plan before utility power failed. Staff were onsite, knew the intended transfer sequence, and could observe load and status directly. The event therefore tested a staged manual arrangement, not an unattended permanent standby system.
The monitoring record shows 23 seconds on battery, 2 hours 47 minutes on generator, and then a return to utility service. The UPS bridged the manual transfer and the later return sequence without a recorded loss of server power.
What the test measured
The useful result was not simply that the generator started. The test exercised a chain:
- The UPS had to recognize the input loss and continue supplying the protected bus.
- The generator had to start, stabilize, and support the connected load.
- The manual transfer had to occur within the available battery window.
- Monitoring and network control had to remain available throughout.
- Return to utility power had to avoid an interruption or unsafe transition.
Each element could pass independently while the full sequence failed. A generator nameplate also says little about actual ride-through unless fuel, starting condition, connection method, load behavior, grounding, protection, and the UPS input window are considered together.
Why the permanent system changed
The staged event showed that the protected load could ride through a deliberate manual transfer while people were onsite. It also showed the limitation: an unplanned failure could occur when no one was standing next to the switch.
After July 4, Helixrack acquired a used permanent 30kW diesel generator. A licensed electrician installed it with an automatic transfer switch. The first recorded automatic operation occurred on August 17. The transfer took eight seconds, with the 30kVA UPS carrying the protected load across the gap.
What happened next
The permanent installation turned a supervised test arrangement into an automatic sequence, but it did not eliminate maintenance. Fuel condition, batteries, starting system, coolant, transfer controls, alarms, load testing, and UPS batteries all became recurring checks. The eight-second transfer was an observed event, not a promise that every future transfer would take the same time.
Any illustration must preserve the timeline. A July 4 scene may show the refurbished UPS and rented towable generator. The permanent genset and automatic transfer switch belong only in the later section. It must not show dark racks, dropped servers, fire, or damage.
The test succeeded because the team staged the equipment before it was needed and measured the complete sequence. Its most important output was the decision to remove the requirement for a person to complete the next transfer.
